Skip to main content

Xenial Digital Menu Boards

Indoor Digital Menu Boards | Installation and Training


Welcome!

Congratulations on getting started with Xenial Indoor Digital Menu Boards (IDMB). This document details and directs to all information needed to feel confident throughout the installation and implementation process.

If at any time there are questions or concerns regarding this process, reach out to the Xenial implementation coordinator via email or by dialing 1-800-547-4266 option 7 (monitored Monday-Friday from 8am-5pm EST).

Installation Process Overview

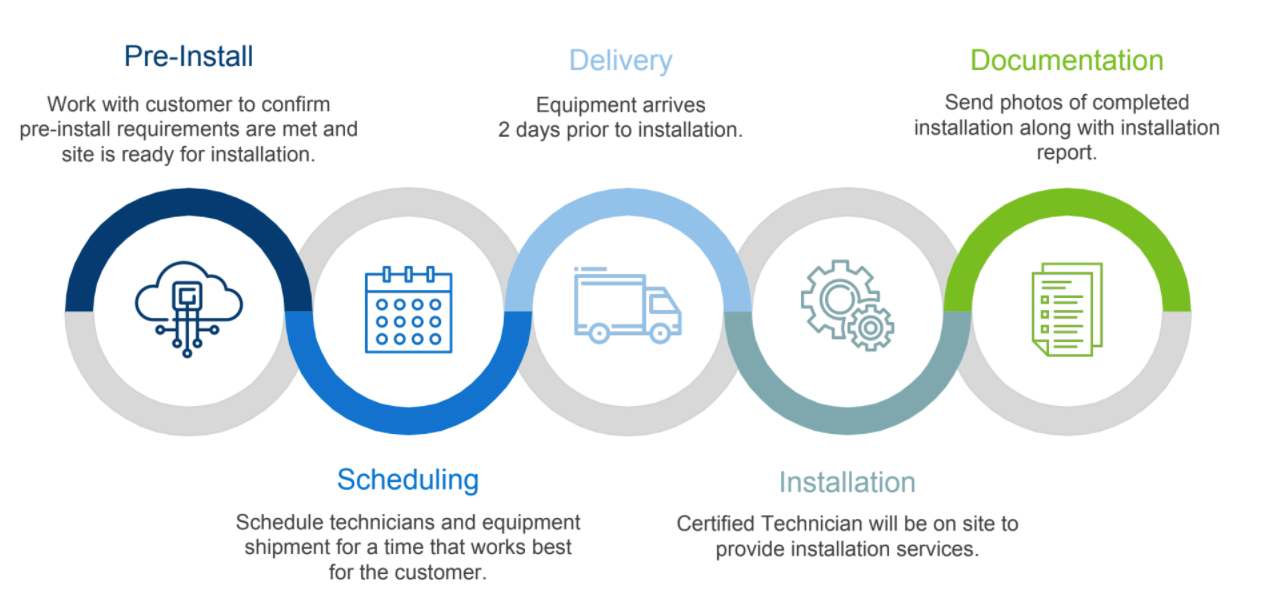

This is a high-level look at the full installation process with the Xenial Team.


Indoor Digital Menu Board Examples

This section outlines the final product install expectations for Digital Menu Boards. A successful install meets the following criteria:

Indoor Digital Menu Boards

  • Screen attached securely to bracket, attached securely to wall or ceiling mount

  • No visible cables

  • Correct content showing on all displays

IDMB Examples


Electrical Overview and Requirements

  • Outlet placement varies and depends on the number of displays. For additional information, see Electrical Outlet Placement.

  • On the breaker panel, clearly label the display(s)—avoid installing the displays on a POS-dedicated circuit.

  • On the same circuit as the display(s), place the Uninterrupted Power Supply (UPS).

  • From the office to the menu board wall, run a conduit (at least 2in (50.8mm) in diameter). A pre-drilled hole or conduit box is also needed on the menu board wall. Use the conduit to run the cables from the displays to their designated network ports.

Electrical Outlet Placement

The most common DMB installations are:

Four Screen Layout

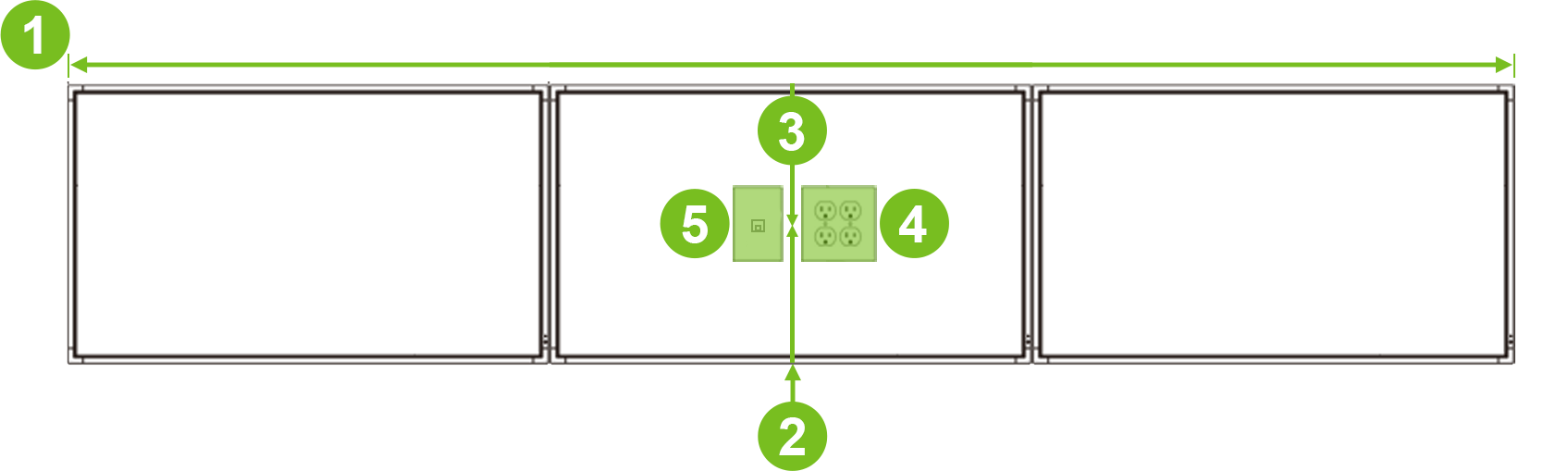

Outlet placement for 4-across configuration.

Two outlets are required for a four (4) screen layout. The outlet placement is as follows:

  1. Measure the wall for the 4-across screen placement.

    • For more information, see the Wall Mount Installation: Swivel document.

  2. Mark the vertical center of the above measurement.

  3. Measure to the right and to the left of the center mark:

    • 43" Display - measure 38.17" from the center.

    • 49" Display - measure 43.4" from the center.

    • 55" Display - measure 49.8" from the center.

    • 65" Display - measure 58" from the center.

  4. Measure 8" from the bottom of the display (Green).

    • Alternatively, if this location is unavailable, measure 8" from the top of the display (Blue).

Three Screen Layout

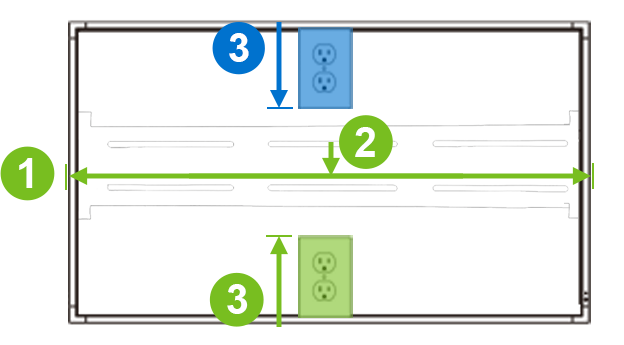

Outlet placement for 3-across configuration.

Two outlets are required for a three (3) screen layout. The outlet placement is as follows:

  1. Measure the menu board wall for the 3-across screen placement.

    • For more information, see the Wall Mount Installation: Swivel document.

  2. Mark the vertical center of the above measurement.

  3. Measure to the right and to the left of the center mark:

    • 43" Display - measure 20" from the center.

    • 49" Display - measure 22" from the center.

    • 55" Display - measure 25" from the center.

    • 65" Display - measure 29" from the center.

  4. Measure 8" from the bottom of the display (Green).

    • Alternatively, if this location is unavailable, measure 8" from the top of the display (Blue).

Three Screen Layout: Alternate Outlet Placement


The alternate outlet placement for a three screen layout requires a quad outlet and a data outlet. The placement is as follows:

  1. Measure the menu board wall for the 3-across screen placement.

    • For more information, see the Wall Mount Installation: Swivel document.

  2. Mark the vertical center of the above measurement.

  3. From the vertical center mark, measure the bracket height and mark the horizontal center point.

  4. Install the quad outlet to the right of the center mark

  5. Install the data outlet to the left of the center mark.

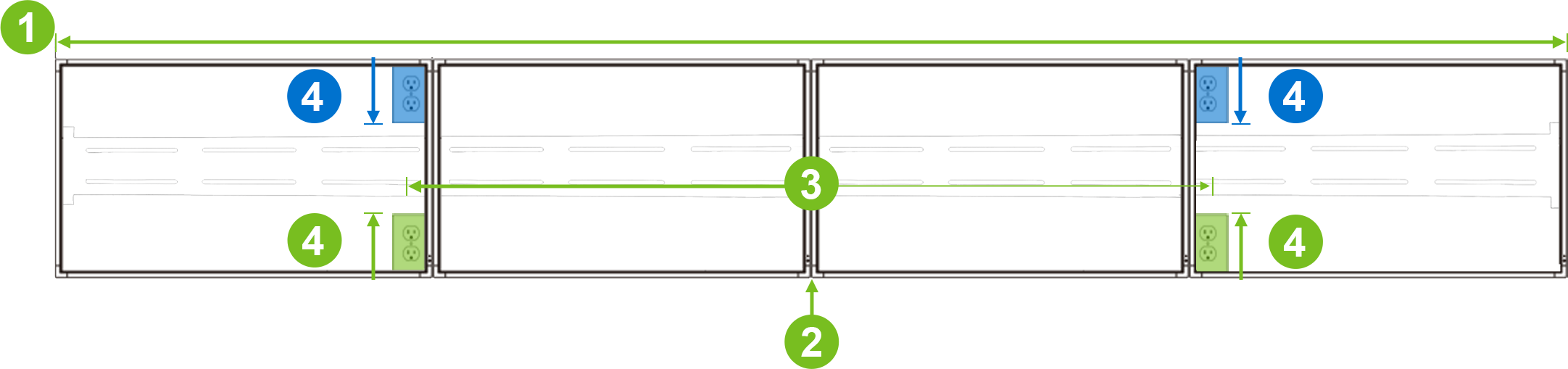

Side Wall Layout

The side wall display requires its own outlet. Outlet placement depends on screen orientation (portrait or landscape).

Portrait

Outlet placement for side wall configuration (portrait).
  1. Measure the wall for the screen placement.

  2. Mark the vertical center of the above measurement.

  3. Measure 2" from the top of the display (Green).

    • Alternatively, if this location is unavailable, measure 2" from the bottom of the display (Blue).

Landscape

Outlet placement for side wall configuration (landscape).
  1. Measure the wall for the screen placement.

  2. Mark the vertical center of the above measurement.

  3. Measure 8" from the bottom of the display (Green).

    • Alternatively, if this location is unavailable, measure 8" from the top of the display (Blue).

Customer and Xenial IDMB Installation Responsibilities

The chart below outlines the specific responsibilities of both the customer and Xenial's installation team.

Customer

Xenial

Pre-installation

  • Remove/dispose of any existing menu boards.

  • Obtain any required permits prior to installation.

  • Complete site-survey or make arrangements for a technician to complete it.

  • Review product documentation

  • Provide for a conduit from the office to the menu board wall for cables to be run.

  • Provide for pre-drilled hole or junction box behind where the displays will be located on the wall.

  • Provide outlets on the menu board wall and in the office according to the DMB Installation Guide instructions, based on display configuration.

  • Menu board wall finished (drywalled, painted, etc.)

  • Provide for permanent power and active internet.

  • Provide networking information and configure site network based on Xenial Network Configuration and Allowlisting Guide.

  • POS should be installed prior to DMB installation.

Installation

  • Have responsible manager onsite to provide approval and sign-off.

Pre-installation

  • Conduct welcome and expectations.

  • Work with customer and contractor to make sure implementation runs smoothly.

  • Ensure that equipment is properly scheduled for shipment.

Installation

  • Run any necessary cables from office to menu board wall.

  • Terminate and connect all low voltage cables.

  • Install and configure screens (and Web power switch, if applicable).

  • Confirm connectivity with Xenial Support.

  • Take pictures and complete installation report.

Xenial Networking Worksheet

In order to ensure that the Xenial equipment is able to communicate properly, the following information is required. If possible, it is helpful to reference the Xenial Allowlisting Guide (obtained from the Xenial installation coordinator) and use the listed settings. Copy and paste this list into an email, provide the information requested, and send to your coordinator.

Network IP Range

Default Gateway IP

Subnet

DNS (primary)

To what network device/firewall port will the Xenial product be connected?

POS Brand

Firewall Provider

Any additional information

Digital Menu Board Allowlisting

The Xenial Digital Menu Board and its components require specific network settings to communicate with the Xenial Cloud Portal, Point of Sale (POS) system, the Order Confirmation Unit (OCU), and other network-connected devices.

If allowlisting is not configured prior to an installation, the digital menu boards may not be able to download content from the Xenial Cloud Portal or download pricing in a POS integrated system. As a result, the Digital Menu Board information within the Allowlisting Guide should be forwarded to the site's network administrator prior to the installation.

The full allowlisting guide is obtained from the Xenial installation coordinator. Please reach out if a copy is needed.

Site Survey

As a part of the installation process, the customer is asked to submit a site survey that provides details on existing conditions so that proper equipment is ordered and to provide opportunity to address issues prior to installation. To have a technician complete the survey, discuss with the installation coordinator.

Indoor Digital Menu Boards

  • Site information, including brand, store number, contact, phone number, and email address

  • Location of the network equipment

  • Make and Model of Internet router

  • Confirm Administrator access available to router

  • Wiring of existing menu boards

  • Details of main menu board wall and any LTO menu board walls. Provide information for each, such as material, dimensions, wall stud type, recommended bracket type

  • List special tools required to drill into main menu board wall

  • Ability for cable to run down menu board wall

  • In the case of a ceiling mount, provide details about the ceiling structure and dimensions

  • Photos of existing signage, walls, ceiling, and office area

  • Confirm understanding of customer's responsibility to obtain all permits

Pre-Install Checklist | Indoor Digital Menu Board

The following identifies the tasks to perform at specific time intervals prior to installation.

Six weeks prior to install

  • All permits required for construction of Indoor Digital Menu Board (IDMB) project obtained.

  • Indoor menu equipment ordered from vendor.

  • Completion of the IDMB site readiness survey. This survey must be completed before equipment can be shipped or the installation can be scheduled.

Two weeks prior to install

  • Devise plan to uninstall and dispose of old menu boards.

  • Ensure that one port per unit is available on network switch/modem/firewall.

  • Outlets in place on menu board wall.

  • All outlets are on a circuit that is dedicated only for the DMB system.

  • Confirm active internet is established or will be established at the time of installation.

  • Confirm site has/will have a PC with an active network connection and that Administrator usernames and passwords are known and kept for the installer.

  • Confirm delivery and installation schedule with vendors.

  • Review Xenial Digital Menu Boards documentation. During the installation, the technician is onsite to complete the physical install only and is not responsible for training staff. The technician also does not have access to the portal or your credentials.

One week prior to install

  • Pre-drilled hole or junction box needed on the menu board wall so we can run the cables down through the wall to come out from behind the screens.

    Importante

    If site owner elects to not run new cabling prior to install, the site owner is responsible for cable connectivity and Xenial is not liable for any subsequent cabling issues that may occur.

  • Confirm POS will be installed prior to IDMB install.

  • Confirm Indoor DMB content and pricing on the Xenial DMB portal.

  • Confirm router is configurable at the site level and that Administrator usernames and passwords are known and kept for the installer.

Five days prior to install

  • Confirm delivery and installation schedule with vendors.

  • Confirm conduit run from the office to the menu board wall so that we can run the cat 5 cables (if applicable per local code).

  • Menu board wall finished (drywalled, painted, tiled, etc)

  • Alert managers of the restaurant that the installation materials will arrive 1-3 business days prior to the confirmed install date.

  • Inform manager to inspect all boxes are present and undamaged before signing for delivery. Contact Xenial right away if there are any damaged boxes.

  • Arrangements made to safely store the equipment until a technician is on site for install.

Three days prior to install

  • Confirm all equipment has been delivered.

  • Contact Xenial if there are any missing or damaged boxes.

Day of install

  • Old menu boards removed (if existing restaurant with boards in place).

  • Authorized person onsite to confirm placement of DMB displays.

  • Authorized person verifies accuracy of pricing and content and can make pricing changes if necessary.

  • Authorized person finalizes the install by signing off on the install report.

Installation Reference Resources

This section details the installation reference materials needed for Indoor Digital Menu Boards. These are provided by the Xenial Installation and Training team and can be resent upon request.

Resource

Description

XDMB Installation Guide

Installation and setup guide for Digital Menu Boards

Allowlisting Guide

Network configuration information for Digital Menu Boards and other Xenial products

Portal User Guide

User access and Digital Menu Board management information

Hardware Data Sheet

The technical specifications for various components of the Digital Menu Board hardware

Getting Help

Need answers? Search product documentation, take a course in the Xenial Academy, or reach out to Xenial Support and communities.

Product Documentation

The Xenial Product Documentation site is accessible via the Help function within the Portal or by accessing this direct link: https://www.xenial.com/product-documentation/?lang=en. Use this site to search or peruse documentation content for Xenial Products.

Training/Xenial Academy

Access will be provided to our Learning Management System (LMS), Xenial Academy, as your training resource throughout implementation. The Academy allows users to revisit the training materials as often as needed during the process.

Access coursework, videos, and supplementary training materials here: Xenial Academy.

Support

Xenial Support is available through various channels, including SMS, WebChat, Web-to-Case, Phone, and Email.

LG Digital Display Replacement

The following provides information about service plans offered by the digital display vendors. In the event a display needs replacement, Xenial Support assists with coordinating replacement services with the vendor. Note that these are standard replacement terms. Individual customer account setup may vary based on contracted agreements.

Nota

Shipments are made during regular business hours Monday through Friday, excluding holidays.

LG ExtendedCare Service Plans

LG's ExtendedCare service plan provides repair and services for all LG display products for a term of five (5) years, depending on the initial purchase agreement. Go to www.LGExtendedCare.com to see the extended care guide.

Service Plan

Description

White Glove Service

  • Three (3) business day exchange where authorized LG technicians deliver and install replacement units at the site(s).

  • End-to-end service includes removal or reinstallation.

  • Technician confirms with Xenial Support that the new display is installed and working.

  • Non-working unit is picked up by FedEx within two (2) days of replacement.

For additional warranty options, please reach out to your Xenial Sales Representative.

Additional Fees

Site Readiness Delays, Cancellations, Rescheduling, and Revisits

A Project Coordinator will email you to discuss and confirm your installation date. Once this date is accepted and confirmed, the following fee schedule will apply:

Category

Description

Cost

Installation Rescheduling

Defined as situations beyond the control of Xenial, which may cause a previously confirmed scheduled installation to be rescheduled prior to the installation date.

Rescheduling between ten and five business days prior to scheduled installation.

$100

Rescheduling between five and two business days prior to scheduled installation.

25% of Installation

Rescheduling two business days prior to scheduled installation.

50% of installation

Rescheduling within 24-hours prior to scheduled installation—does not include weekends.

75% of installation

Onsite Cancellation

Defined as situations when a technician arrives on site and is unable to install due to issues with customer site readiness responsibilities.

100% of installation

Wait Time

Defined as situations in which the installation is delayed due to issues with customer site readiness responsibilities.

$235/hour

* Wait time in excess of two hours may result in cancellation and rescheduling of the installation.

Installation Revisit

Defined as situations when Xenial is required to return to a site to complete the original installation at a later date, due to issues with customer site readiness responsibilities.

$235/hour + $125 per site travel fee

* Any warranty revisits that are not billable to the customer will be scheduled and performed as soon as possible.

Expedited Installation

When installation is necessary to take place within 4 weeks of order and/or payment.

30% of actual install fee may be billed as an expedited install fee

Expedited Shipping

When shipping is delayed due to customer's lack of payment or required documents.

Customer will pay actual expedited shipping fees.

Things to Know

How long is the shipping process?

4-6 weeks from the order date.

Is self-installation an option?

Contact the Xenial coordinator for more information.

What are the pre-install and install day responsibilities?

Customer and Xenial IDMB Install Responsibilities lists these responsibilities. Contact the Xenial coordinator with any questions.Customer and Xenial IDMB Install Responsibilities
